vACDM

vACDM

What is vACDM

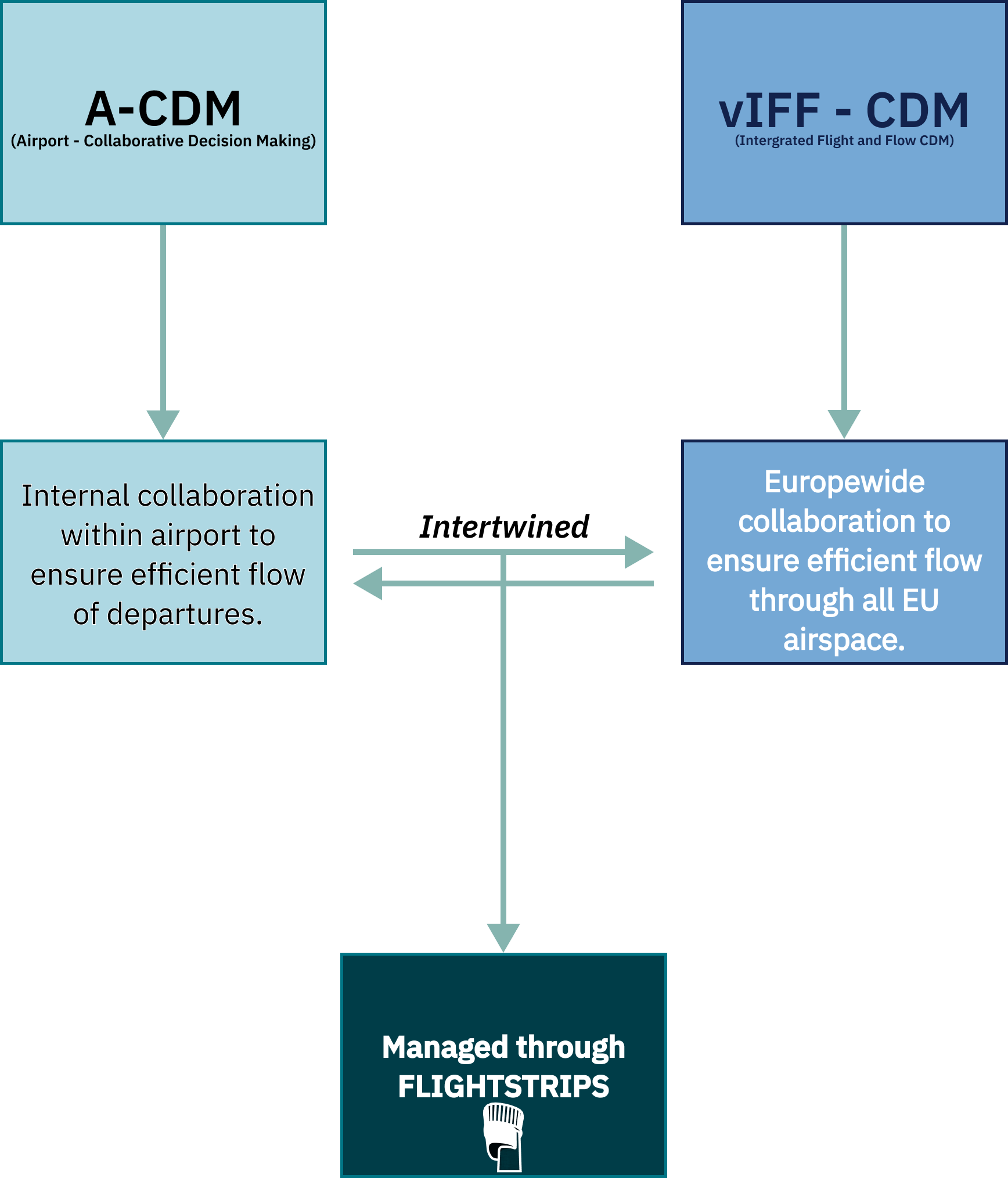

vACDM is the second generation of CDM plugins which helps us manage start-up times in order to minimize delays and queues at the holding points.

vACDM is MANDATORY to use if you sit on EKCH_DEL

Abbriviations for CDM

EOBT : Estimated off block time

TOBT: Target off block time

TSAT: Target Start Up Time

ASRT: Requested Start Up Time

TTOT: Target Takeoff Time

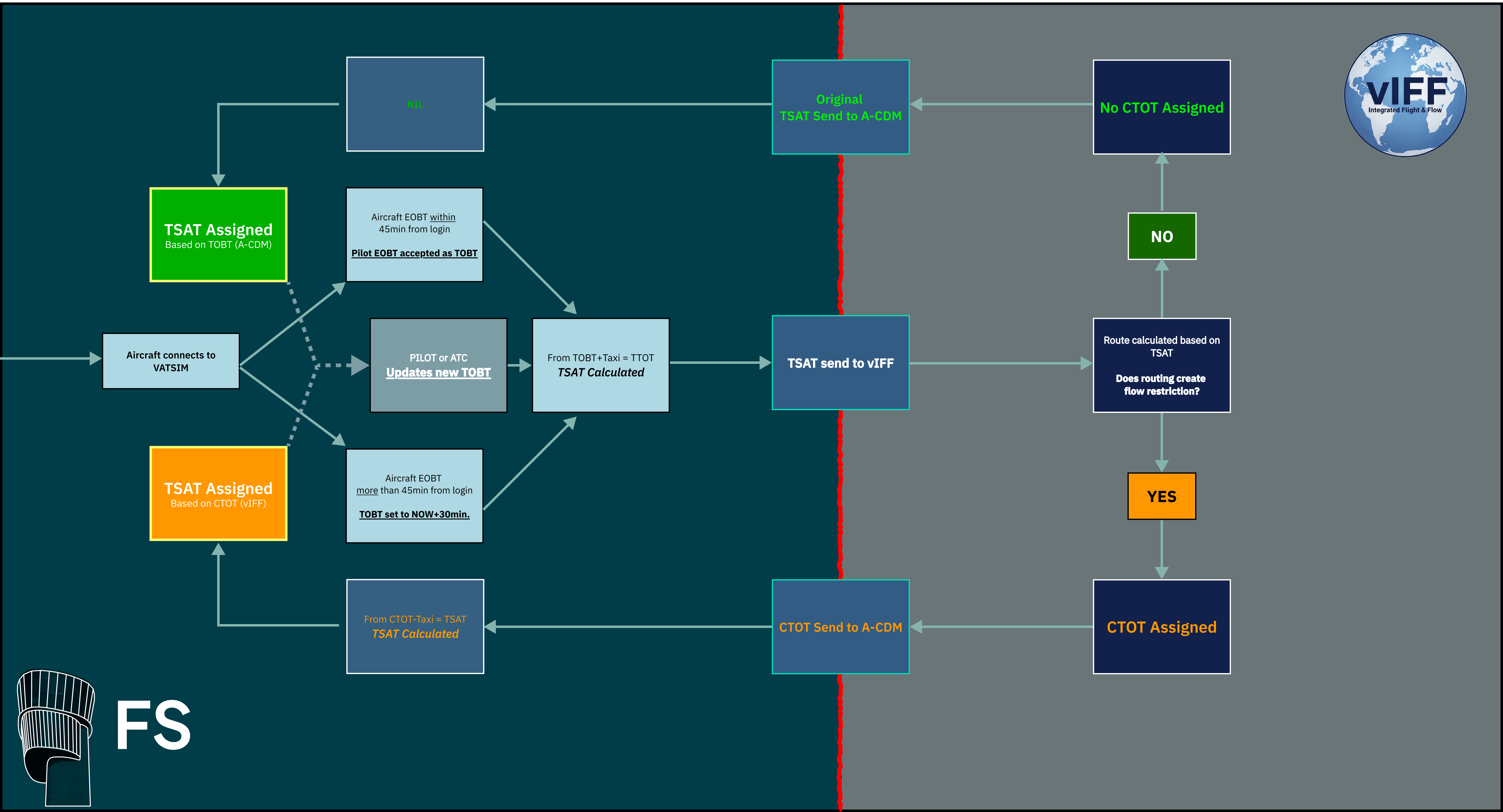

What does it all mean?

Quick Breakdown for the basic rules

EOBT is always filed as part of the flight plan

TOBT is filed and changed during the boarding as predicted ready time may be changed back and forth. Pilot can freely choose this time. It is essentially a "Fine Tuning" of EOBT

TSAT is the time the CDM has targeted the pilot to start up on. This is based on

ASRT is purely a marker you use to remind yourself pilot has requested start-up

ASAT is the time he has been given startup which is also in a way a marker.

Pilots KNOW their TOBT (it is filed by them)

Pilots DO NOT know their TSAT (It is constantly changing and is calculated by the system)

What to expect from Pilots

  1. Pilot have a off block time or EOBT. This is filed with the flightplan
  2. TOBT is automatically calculated and will initially be identical to the EOBT
  3. Pilots will access "cdm.vatsim-scandinavia.org" to "Confirm" their off block time. This should be done by pilots who want to avoid extensive delay, but is not mandatory


Pilots shall call within +/- 5 minutes of their TOBT (the one they know)

Start-up shall only be granted within +/- 5 minutes of the TSAT (the calculated one)

vACDM

User guide & Procedures

How to Start vACDM

As the first thing when you log on you must activate vACDM to use it

Write .vacdm master to activate

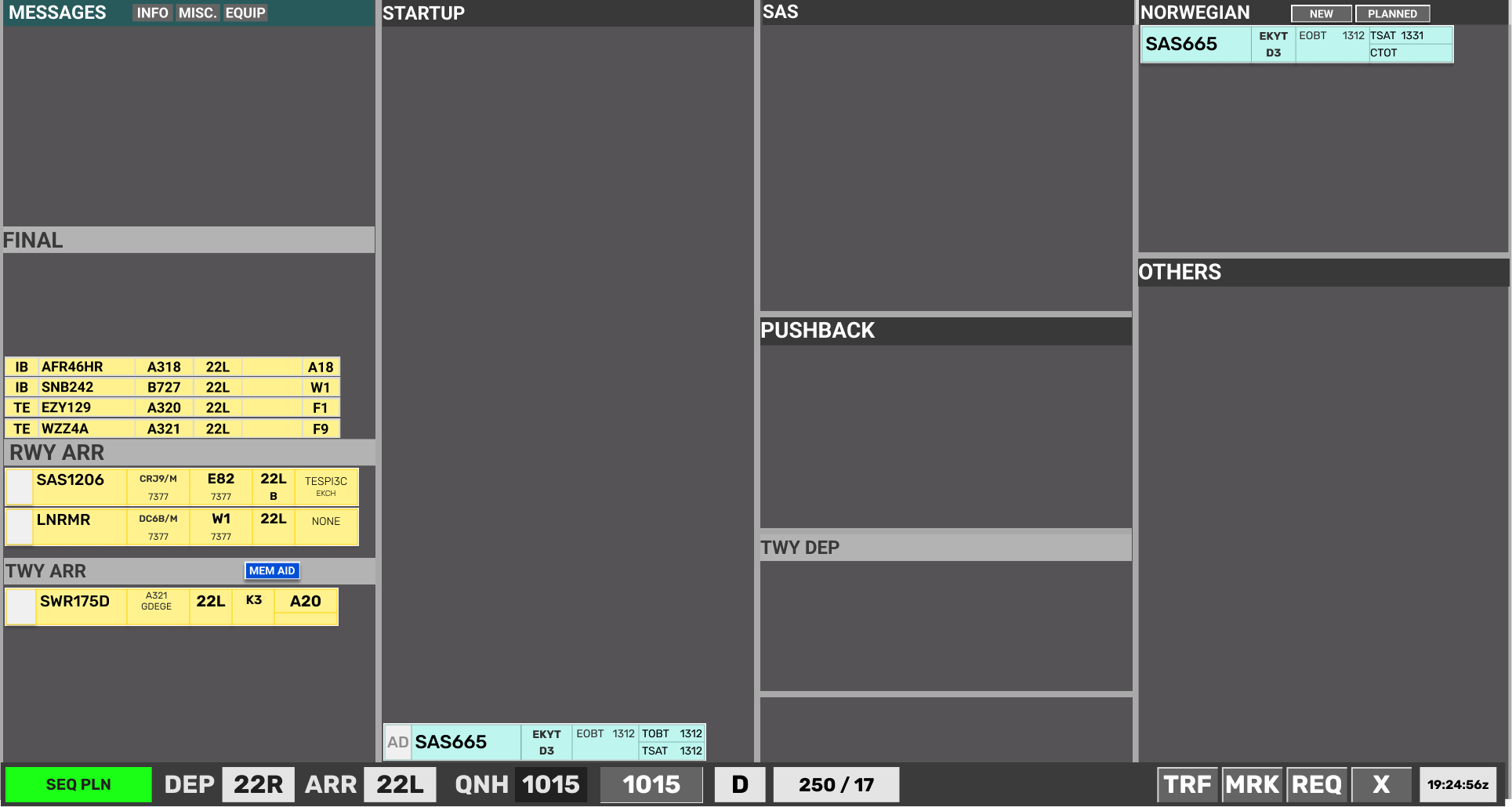

Now you should see something like this in your startup list.


Press on the top of the TSAT collumn where it says TSAT! This orders the list after that and makes it easier to manage

EOBT; TOBT; TSAT; ASRT,ASAT,CTOT

Colors

There are different colors which represents different timings. They may seem complicated but you learn them fast.

Explanations

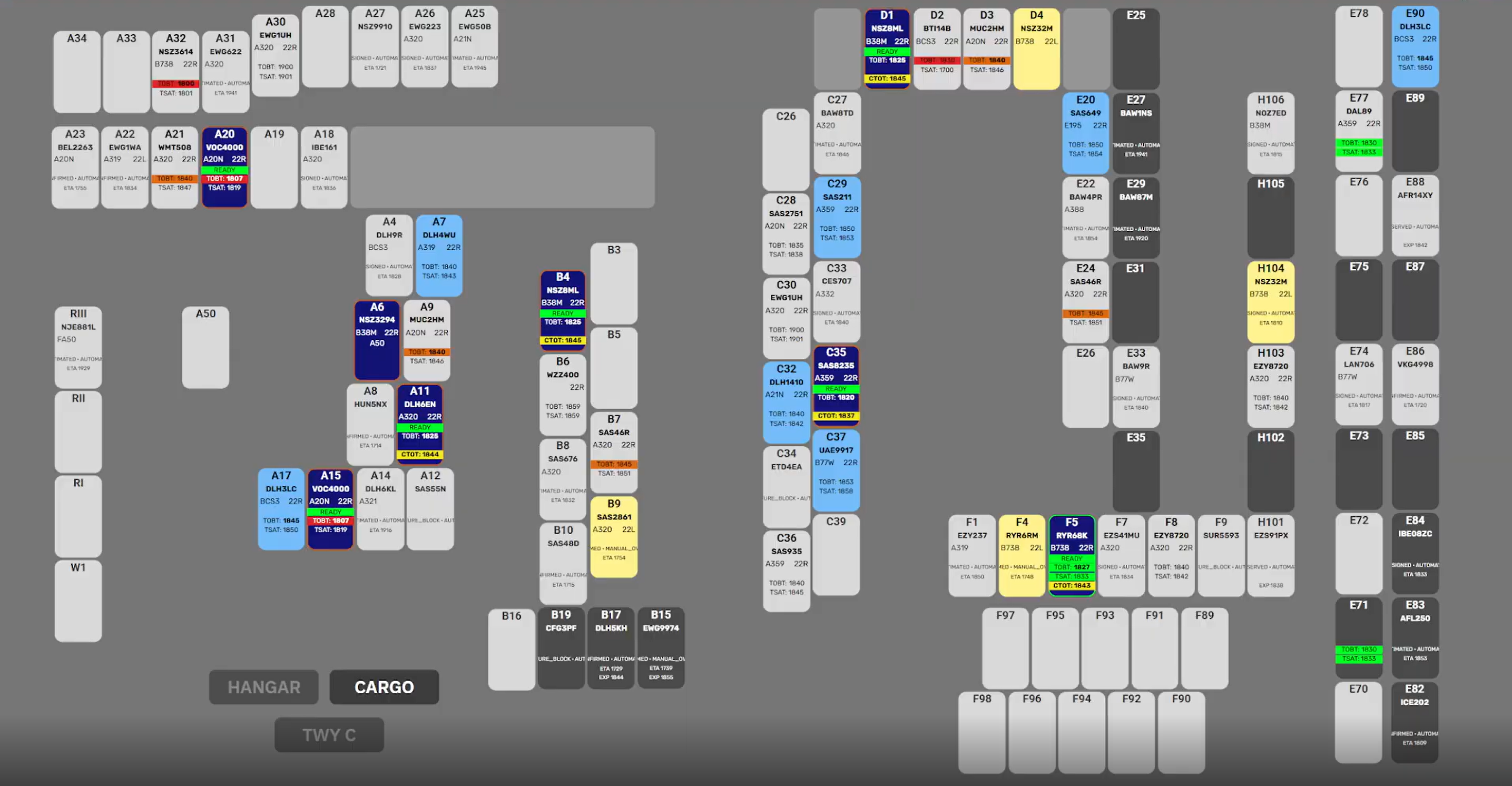

Here is the start-up list sorted for TSATs. See for each number what is happening


  1. DLH9EWs TSAT is expired.
  2. SAS51P has filed EOBT at 1752.
    • He has CONFIRMED his TOBT to be 1755 which is why it is DARK GREEN.
    • His TSAT is 1755, and is within the 5 minute window for startup. He can be approved for startup
  3. THY39 has filed EOBT at 1755,
    • He has NOT confirmed the TOBT, which is why its LIGHT GREEN.
    • His TSAT is 1755, and is within the 5 minute window for startup. He can be approved for startup
  4. EWG4JH has filed EOBT at 1820
    • He has CONFIRMED his TOBT for 1756, which is why it is DARK GREEN.
    • his TSAT at 1800 is LIGHT GREEN. because he is NOT yet within his 5 minute window for startup.
    • He must wait until 1755 at the earliest (TSAT-5), OR change his TOBT
  5. EJU73UA has filed EOBT at 1800
    • He has CONFIRMED his TOBT for 1754. which is why it is DARK YELLOW.
    • These are DARK YELLOW because they are confirmed, but they are providing him with more than 5 minutes delay between his TOBT and TSAT.
  6. SAS78DL has filed EOBT at 1800
    • but has NOT confirmed the TOBT which is why it is LIGHT YELLOW
    • These are LIGHT YELLOW because they are unconfirmed and are providing him with more than 5 minutes delay between his TOBT and TSAT.
  7. ETH725 has requested startup, but is not yet within 5 minutes of his TSAT.
    • ASRT is marked in DARK GREEN, for tactical marker,
    • He must still wait until TSAT turns DARK GREEN as well.
  8. VKG11 already had startup approved,
    • ASAT is DARK GREEN and all the rest is Grayed out.
    • He is on his way to Apron for Pushback

Procedures

Following steps are needed while using vACDM. It is not difficult be takes a few minutes to get used to

TOBT does not have to be confirmed for pilot to request pushback. It is only to give a more precise indication

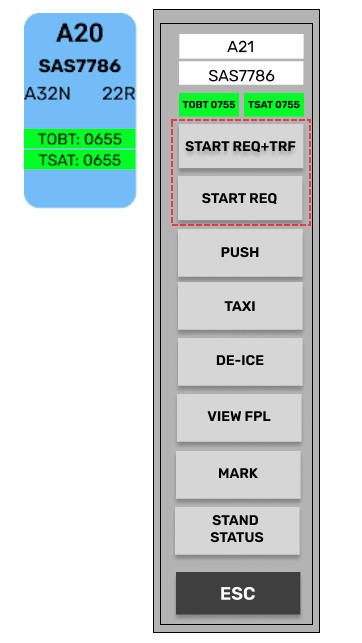

Whether pilot has TOBT confirmed or not does not require anything from you. You can confirm it for him by Left clicking on the TOBT and select one of the following from the  "TOBT menu"


If you edit the TOBT the TSAT may get changed to reflect the TOBT as well

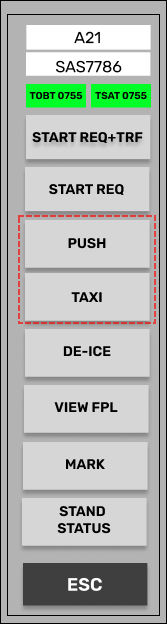

Pilot requests startupimage.png

This gives you Three options depending on the color of the TOBT & TSAT. These three scenarios will guide you to what to do


Scenario 1: DARK GREEN TSAT



Call has correctly be made within TOBT +/-5 and TSAT is within the window for startup.






Left click on TSAT to Assign Start-up and observe ASAT time being activated and rest of "line" grayed out.


Scenario 2: YELLOW TOBT (dark/light), LIGHT GREEN TOBT


Pilot has called (probably) within his TOBT time but a delay is expected due to traffic congestion.







Click on ASRT to mark he has requested start up, and wait until pilot is within his TSAT window


Scenario 3 Green TOBT (dark/light), LIGHT GREEN TSAT


Pilot has called before his TOBT. Set TOBT to "now" by either:






Doing this will result in one of two scenarios

Once start-up is approved, hand over to apron and that is done.
